How Long Does It Take to Design and Install a Mezzanine Floor?

You have reviewed numerous industry publications on mezzanine floor design and installation timelines and understood that the common question, “How long will it take?” doesn’t have a one-size-fits-all answer. The timeline depends on several factors, including design complexity, permitting requirements, installation logistics, and, budget. Typically, mezzanine projects range from 6 to 36 weeks or longer. So, how long does it really take?

  • 0
  • 6
  • 0
  • 6

Contents

Not Sure How This Applies to Your Business?

icon blcok
503-640-5666

or

Mezzanine Floor Construction Timeline

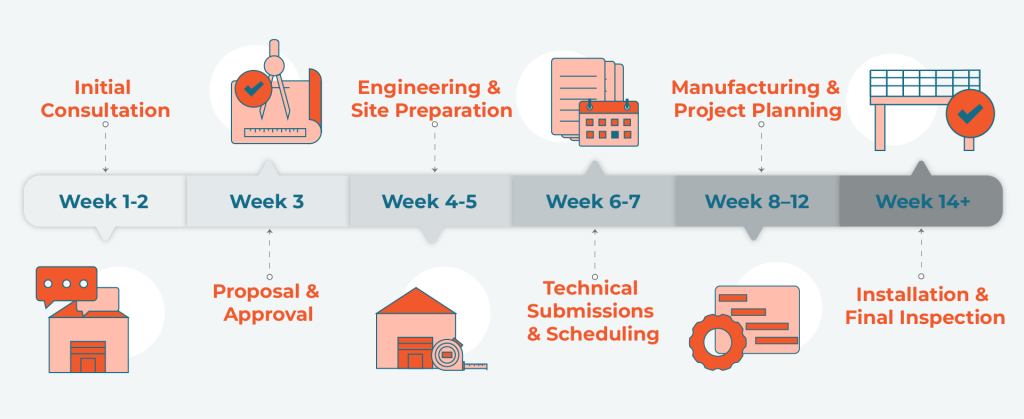

Mezzanine Floor Construction Timeline

Week 1-2: Initial Consultation

  • Speedrack West: Visits your site, takes measurements, reviews your operation, and discusses mezzanine goals and constraints.
  • Customer: Provides access to the facility, explains current pain points and future plans, and shares any existing drawings or photos.

Week 3: Proposal & Approval

  • Speedrack West: Prepares a detailed quote and mezzanine layout, answers questions, and updates the design if needed.
  • Customer: Reviews the proposal, confirms final layout and specs, and places an order (including any required deposit) to start manufacturing.

Week 4-5: Engineering & Site Preparation

  • Speedrack West: Sends an engineer for detailed structural measurements and arranges slab core sampling if slab data is missing.
  • Customer: Provides site plans, block plans, floor slab details (if available), and approves any slab testing or site access needed.

Week 6-7: Technical Submissions & Scheduling

  • Speedrack West: Compiles and submits drawings, calculations, and slab information to Building Control and books a production slot with the fabricator.
  • Customer: Signs any required application forms, responds to authority questions, and aligns any general contractor or key trades with the target schedule.

Weeks 8–12: Manufacturing & Project Planning

  • Speedrack West: Manages steel fabrication and builds a detailed project schedule covering fire rating, storage, offices, and other scope items; coordinates with third-party trades as needed.
  • Customer: Confirms installation windows, prepares the site (clears areas, plans around shutdowns), and keeps external contractors (electrical, fire, IT, GC) aligned with the timeline.

Week 14+: Installation & Final Inspection

  • Speedrack West: Installs the mezzanine per the agreed schedule, completes a walk-through, compiles documentation, and schedules final inspection with Building Control.
  • Customer: Maintains safe access to the work area, ensures third-party trades complete their work and provide certifications, and signs off on the finished installation.

Post-Installation Compliance

  • Speedrack West: Can help coordinate a certified fire risk assessor and advise on any follow-up safety measures.
  • Customer: Arranges and completes a new fire risk assessment and implements any actions required by the assessor or authorities.

Want Help Owning Your Part of the Timeline?

We’ll help you understand each step, your role, and what a realistic design-through-installation timeline looks like for your facility.

Project 1: A Small Warehouse Pallet Rack Mezzanine – 6 to 10 Weeks

Example. Consider a medium-sized distribution center or any commercial company in need of additional storage space to store lightweight, fast-moving goods in its 10,000 sq.ft warehouse. Since the company already used pallet racks, a pallet rack-supported mezzanine was the optimal choice to increase vertical storage.

Specifications

  • Dimensions: 50 ft x 30 ft (1,500 sq. ft.)
  • Load Capacity: 125 lbs/sq. ft. (light inventory)
  • Flooring Material: Open steel grating (for fire code compliance & airflow)
  • Integrated Equipment: Safety railings, rolling safety gate for pallet loading

Timeline

  • Week 1-3: Design, structural calculations, and approvals
  • Week 4-7: Manufacturing and material preparation
  • Week 8-10: Installation, final inspection

Why this design? The open steel grating allows sprinkler systems to function efficiently, avoiding the need for costly fire suppression modifications. The simple design will result in faster approval and installation than more complex mezzanine warehouse floors.

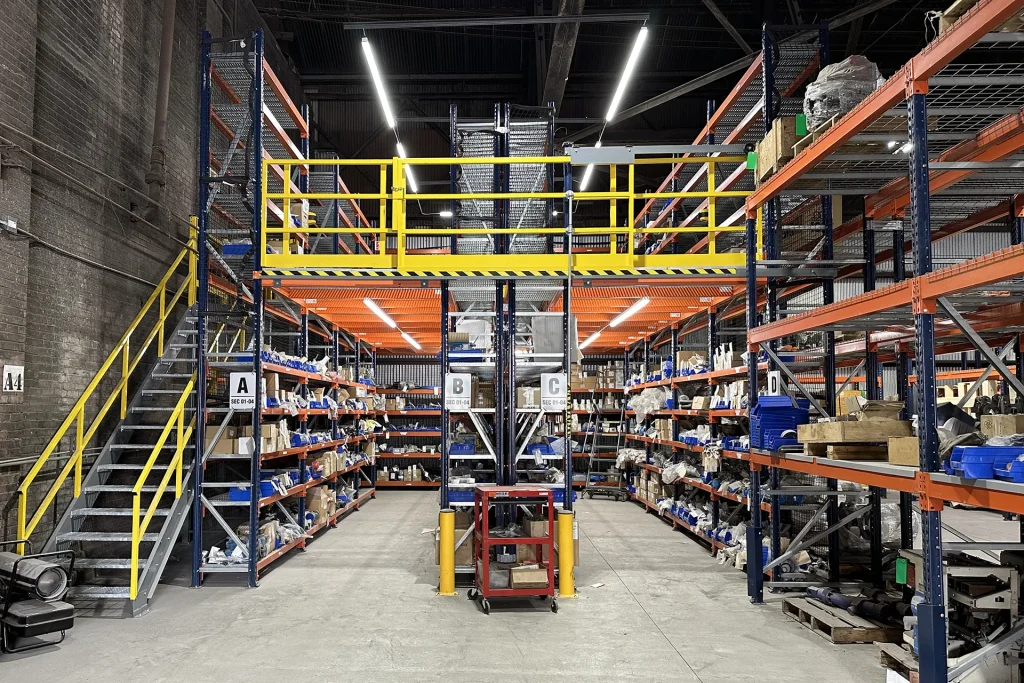

A Small Warehouse Pallet Rack Mezzanine

Project 2: Medium-Size High-Capacity Pallet Rack Mezzanine with Conveyor Integration – 12 to 22 Weeks

Example. A wholesale supplier needs a high-capacity pallet rack mezzanine in its 25,000 sq. ft. warehouse to handle order fulfillment and picking operations while maximizing pallet storage below. The lower level will store bulky palletized goods, while the mezzanine will be used as a pick-and-pack area for smaller items. A conveyor system will be integrated to transport packed orders from the mezzanine to the shipping area efficiently.

Specifications

  • Dimensions: 80 ft x 50 ft (4,000 sq. ft.)
  • Load Capacity: 150 lbs/sq. ft. (bulk inventory)
  • Flooring Material: Resin-coated plywood (cost-effective, smooth surface for conveyor operation)
  • Integrated Equipment: Motorized conveyor system, pallet drop zones with safety gates

Timeline

  • Week 1-5: Structural engineering, permit approval, and conveyor system planning
  • Week 6-11: Fabrication of steel framework and mezzanine flooring
  • Week 12-20: Installation, electrical work, and conveyor integration

Why this design? The lower level stored bulky palletized goods, optimizing space for a large inventory. The mezzanine level was designed as a picking and packing area for high-demand products. The conveyor system automated the movement of packed orders from the mezzanine to shipping, reducing manual labor and improving workflow efficiency. The resin-coated plywood flooring provided a smooth surface for employees using rolling carts and hand trucks.

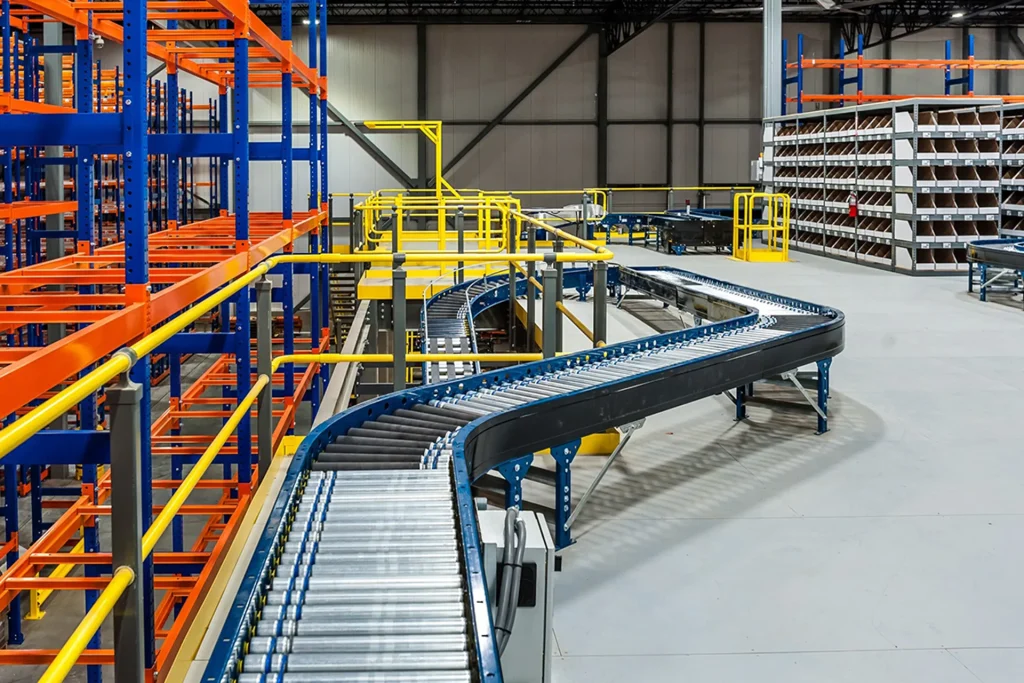

Pallet Rack Mezzanine with Conveyor Integration
Image Credit: Wildeck¹

Project 3: Structural Mezzanine for Manufacturing Expansion – 20 to 36+ Weeks

Example. A manufacturing plant needed a multi-level structural mezzanine to expand production space without relocating. The company requires a durable, high-capacity solution to support heavy machinery and workstations while maintaining efficient storage and workflow on the ground level.

Specifications

  • Structure: Built using a structural steel mezzanine with heavy-duty columns and beams.
  • Dimensions: 120 ft x 80 ft (9,600 sq. ft.) across two levels.
  • Load Capacity: 500+ lbs/sq. ft. (engineered to hold machinery and manufacturing equipment).
  • Flooring Material: Heavy-duty steel plate with anti-slip coating for industrial use.
  • Integrated Equipment:
    • Vertical Conveyor (VRC) for moving materials between levels.
    • Forklift access zone with reinforced pallet drop areas.
    • Electrical wiring & outlets for machinery operation.

Timeline

  • Weeks 1-8: Load analysis, structural engineering, and permitting.
  • Weeks 9-16: Fabrication of steel components and foundation preparation.
  • Weeks 17-36+: Staged installation, electrical work, and safety inspections.

Why this design? Since the existing pallet racking could not be modified to support the required load, the company chose a dedicated structural steel mezzanine. The lower level remained a high-density pallet storage area, while the upper level provided workspace for equipment and workers. Steel plate ensured the mezzanine could withstand constant machinery vibrations and forklift traffic. The project included guardrails, fire safety measures, and a controlled forklift access zone.

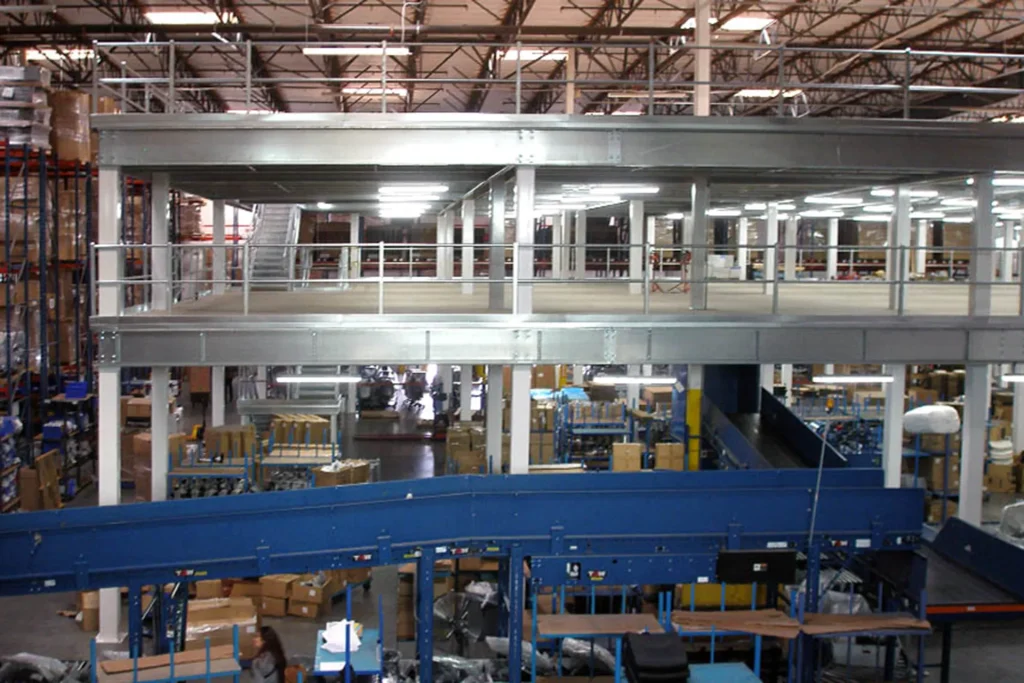

Mulit Level Mezzanine Manufacturing
Image Credit: FCP²

Why Choosing the Right Partner Matters

So, the right pallet rack mezzanine depends on your:

  • Storage & operational needs (bulk storage or high-movement inventory)
  • Load capacity requirements (light-duty or heavy-duty)
  • Flooring materials (grated steel, plywood, or solid steel plate)

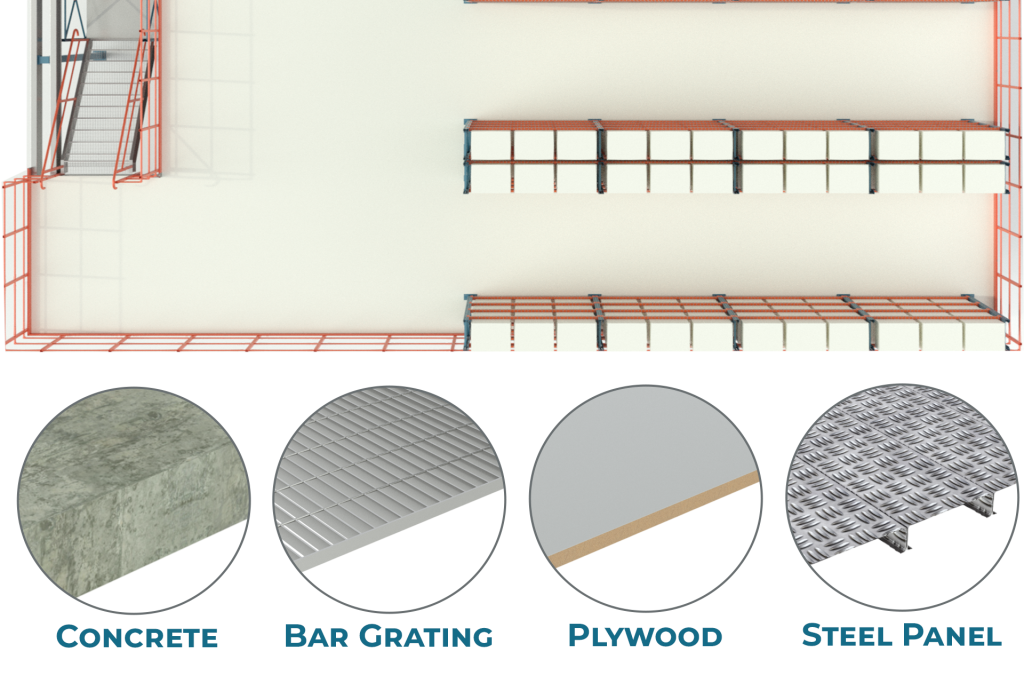

Flooring Options
  • Integration with other equipment (conveyors, VRCs, pallet drop zones)
Mezzanine with Conveyor

The most simple way to achieve a smooth, efficient mezzanine installation is to work with a single provider that manages everything — from concept to completion.

That’s where we come in. Our in-house design and installation team understands the complexities of mezzanine construction, ensuring each project is executed precisely and efficiently. By overseeing the entire process, we often complete projects faster than the industry average—without cutting corners.
